Canal Rehabilitation: How to Reline a Damaged Canal
Quick Summary
A guide to canal rehabilitation by overlining: condition assessment, method selection by existing lining, void filling, thickness from current design velocity, and when overlining is not suitable.

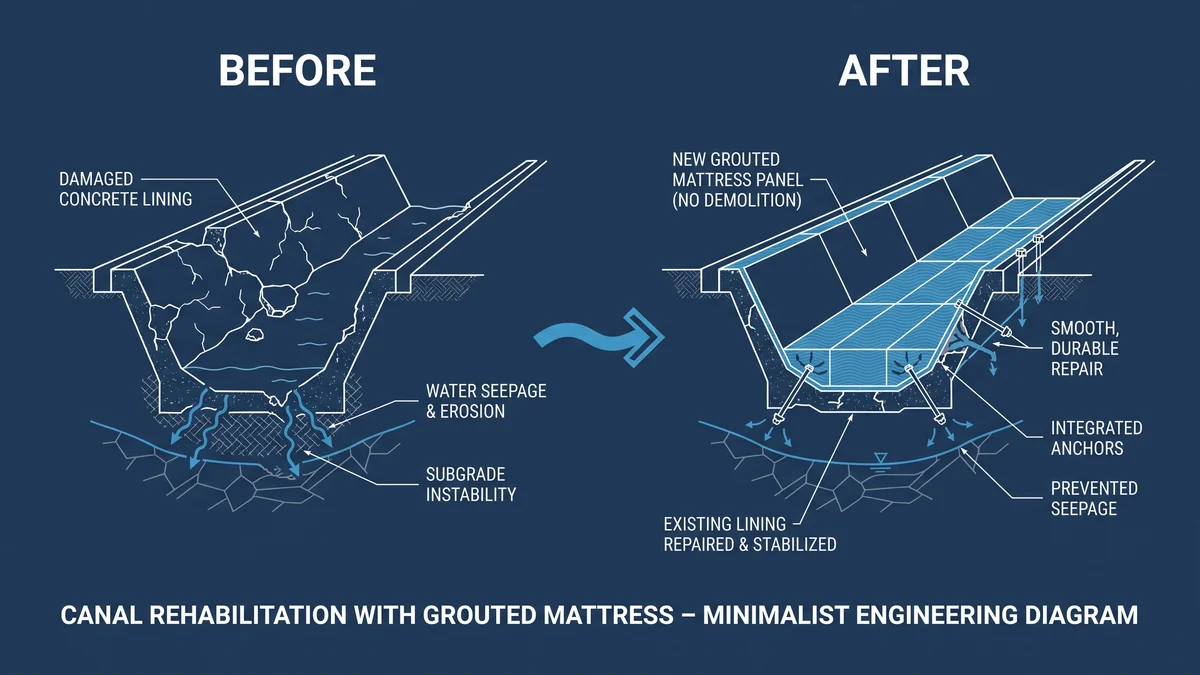

Many canal rehabilitation projects can reline directly over the existing lining, avoiding full demolition, provided the structure is stable and voids beneath it are treated first. Grouted mattress suits this because the fabric drapes over an irregular, cracked or settled surface. Choose the method from a condition assessment, set the thickness from the current design velocity, and keep overlining for sound subgrades only.
Many irrigation canals were built decades ago and are now at or past the life their designers expected. Concrete linings crack at construction joints, clay blankets consolidate and develop preferential seepage paths, and old riprap displaces after major floods and leaves exposed banks. Full demolition and replacement is slow and disruptive, so overlining is a standard approach where the existing structure allows it.
This guide walks through the three phases of a canal rehabilitation project: condition assessment, method selection and installation. For the hydraulic design of a new lining, see Canal Lining Methods: Complete Comparison. For seepage losses and economics, see Canal Seepage Control: Methods, Costs, and ROI.
Phase 1: Condition Assessment
A systematic assessment drives method selection, so do it before choosing a product. It should document:
- Seepage loss: a ponding test on isolated reaches (see the seepage control guide) to quantify current losses and rank reaches for rehabilitation.
- Lining inventory: existing lining type (concrete, clay, riprap, compacted earth), thickness and age, from as-built drawings or core samples.
- Defect mapping: a visual inspection recording crack locations, joint failures, erosion holes, slope subsidence and vegetation intrusion. Grade each defect as minor (surface crack only), moderate (full-depth crack or open joint) or severe (displaced panels or erosion holes).
- Subgrade condition: is the lining structurally stable, or has it moved? If it has settled into voids beneath it, overlining without void filling means the new lining bridges the same voids.
- Hydraulic survey: confirm the cross-section still matches the design. Siltation, erosion and settlement can change the hydraulic profile over time.
Phase 2: Choosing a Rehabilitation Method
Match the method to the existing condition. The table sets out the usual approach for each condition, and the project designer confirms the final choice from the assessment.
| Existing Condition | Usual Rehabilitation Method | Notes |
|---|---|---|
| Cracked concrete, surface cracks only, panels stable | Overline with grouted mattress | Mattress covers the cracks; no demolition needed |
| Cracked concrete, joints open, panels displaced slightly | Grout-fill joint voids, then overline | Void fill prevents bridging; small movements are within the mattress's tolerance |
| Concrete with panels badly displaced or tipped | Remove displaced panels, regrade, then overline | Partial demolition only, of the displaced sections |
| Failed clay blanket, erosion holes, loss of profile | Regrade and compact the clay, then overline | Clay provides the subgrade; mattress provides durable armor |
| Displaced riprap, stone gaps, filter exposed | Overline directly | Fabric drapes over the stone surface and grout fills voids |
| Full-section failure, slope collapse or piping | Geotechnical investigation, then reconstruction | Overlining is not appropriate where the subgrade has failed structurally |
Phase 3: Installing Grouted Mattress Over an Existing Lining
Overlining differs from new construction in three ways.
Difference 1: Subgrade Tolerances Are More Forgiving, Within Limits
The fabric's flexibility lets it drape over moderate surface irregularity, so the existing lining does not need to be perfectly flat. Deeper depressions should still be filled with grout or compacted fill before overlining. Otherwise the mattress bridges the depression and leaves an unsupported span that can crack under load. The tolerance for each project is set in the specification.
Difference 2: Void Filling Before Overlining
Where concrete panels have settled into voids beneath them, which you can often detect by the hollow sound when tapped, those voids must be pressure-grouted through drilled holes before the mattress is placed. The hole pattern and grout mix are set by the designer from the survey. Unfilled voids create the same bridging problem as surface depressions.
Difference 3: Thickness Is Set From the Current Design Velocity
Rehabilitation is a chance to upgrade the lining to the present hydraulic requirement, which may be higher than the original if canal capacity has increased. Specify the thickness from the current design velocity using the rating table, and do not add credit for the old lining underneath. Whether the old lining contributes anything to the new section is an engineering judgment for the designer, not an assumption to build into the specification.
| Thickness | Rated Design Velocity |
|---|---|
| 75 mm | Up to 2.5 m/s |
| 100 mm | Up to 3.5 m/s |
| 150 mm | Up to 4.5 m/s |
| 200 mm | Up to 6.0 m/s |
Rehabilitation or Full Replacement: How Do You Compare Them?
Program length and closure time depend on the canal, the season, the number of pumps and the crew, so this guide gives no weeks per kilometer. Compare approaches on these points instead:
- Demolition scope: overlining avoids most of it; replacement does not.
- Canal closure: overlining can often proceed reach by reach, while full replacement usually needs longer outages.
- Dewatering and diversion: how much of the section must be dry, and for how long.
- Disposal and haulage: demolition produces material that must be moved.
- Remaining life of the structure: overlining adds protection to a stable structure; it does not fix a failed one.
Ask each bidder for a method statement and a reach-by-reach program, and compare closure time and scope together. HydroBase prices each project individually from the design velocity, area and location you send.
What to Confirm Before You Specify an Overline
An overlining specification is as sound as the assessment behind it. Before the tender goes out, have the designer confirm each of these in writing:
- The defect map covers every reach in the scope, and each reach has a stated treatment from the table above.
- Void filling is scoped as its own item, with the hole pattern and grout set by the designer and a named person to record where it was done.
- The thickness is set from the current design velocity, with the old lining given no credit unless the designer states otherwise.
- The reduced cross-section has been checked against the hydraulic capacity the canal must carry.
- Terminations at gates, culverts, bridges and drops are detailed on the drawings, because these edges are where overlining meets structures it cannot cover.
- Closure windows, diversion arrangements and any dewatering are agreed with the scheme operator.
- Grout sampling and curing records follow the project specification and have a named owner.
If any item is open, resolve it before pricing. Bidders who price an incomplete scope will fill the gaps with assumptions, and those assumptions surface later as variations.
Inspection and Hand-Over After Relining
Hand-over is the moment to capture the condition that future inspections will be compared against. The owner should receive, at minimum, an as-built survey of the finished section, a record of where void filling was done, the grout and curing records the specification required, and dated photographs of each reach before and after overlining.
Walk the finished lining with the supervisor and note every visible defect, however small, in a defect log. Look at panel joints, terminations at structures, the toe and the crest anchorage, since these are places where problems tend to appear first. Plan a first inspection after the canal returns to service and another after the first significant high flow, comparing against the hand-over record. Local damage found early is a patching job, while damage found late can expose the old lining and subgrade again. Set inspection intervals in the owner's asset plan, not in this guide.
When Is Overlining the Wrong Answer?
Overlining is not a repair for structural failure. If the embankment is slipping, the subgrade is piping, or the canal bed has lost its profile through erosion beneath the lining, put the geotechnical fix first. A mattress laid over a moving slope moves with it. Overlining also reduces cross-section slightly, so check the hydraulic capacity, especially on canals already running near full capacity. For related failure mechanisms, see canal lining failure causes and prevention.
What This Means When You Order for a Rehabilitation Project
For a relining scheme, the most useful thing to prepare is the condition survey: lining type, defect photographs, the reaches you want treated first and any voids found. Add the current design velocity for each reach, the canal length, the location and the drawings. Pricing is by project, so these items replace a list rate.
The thickness range of 75 to 200 mm is matched to velocity, from 2.5 m/s at 75 mm to 6.0 m/s at 200 mm. Stock sizes dispatch in 3 to 5 days, and custom-size panels take 5 to 7 working days to produce at the factory in Inner Mongolia, China, which helps when you are fitting a reach-by-reach program into a closure window. Send the survey through the contact page; the engineering team replies within 48 hours.
Sources and Further Reading
Open each document to confirm its current edition and scope before you rely on it.
- FAO, Lining of Irrigation Canals: FAO publication on lining irrigation canals. Checked 2026-10-24 (link and title).
- FAO canal lining chapter: FAO chapter on canal lining. Checked 2026-10-24 (link and title).
- ICID, About the Commission: The International Commission on Irrigation and Drainage. Checked 2026-10-24 (link and title).
- Geosynthetic Institute specifications index: Index of GRI test and specification documents. Checked 2026-10-24 (link and title).
Frequently Asked Questions
Can grouted mattress be installed over existing concrete without dewatering?
The upper slope can often be installed with the canal at low flow, while the invert and lower slope usually need dewatering or diversion within the limits of the method statement. A reach-by-reach program lets rehabilitation proceed without interrupting supply to the whole scheme.
How thick should the overline be on an existing concrete lining?
Thickness is set from the current design velocity, using the rating table, not from the old lining. Where velocity has increased since the original design, specify for the current value regardless of the existing condition. Whether the old lining adds any reserve is a judgment for the designer.
How long does canal rehabilitation with grouted mattress take?
It depends on the reach length, access, number of pumps, crew, season and how much void filling is needed. The contractor's method statement sets the program. Planning work for a dry season or low-demand period reduces the impact on supply, and a reach-by-reach program extends the total duration.
What do I need to send for a rehabilitation recommendation?
Send the condition survey, the existing lining type, defect photographs, current design velocity, canal length, location and any drawings. The engineering team replies within 48 hours and will tell you whether overlining looks suitable or whether investigation is needed first.
To discuss a project, send HydroBase your canal condition survey, design velocity, length and location and the engineering team will review it and suggest a rehabilitation approach.
HydroBase Technical Team
HydroBase manufactures grouted mattresses (GRI GT16 compliant) in China and delivers to 30+ countries. Our engineering team provides specification support, grout mix design, and installation guidance.
