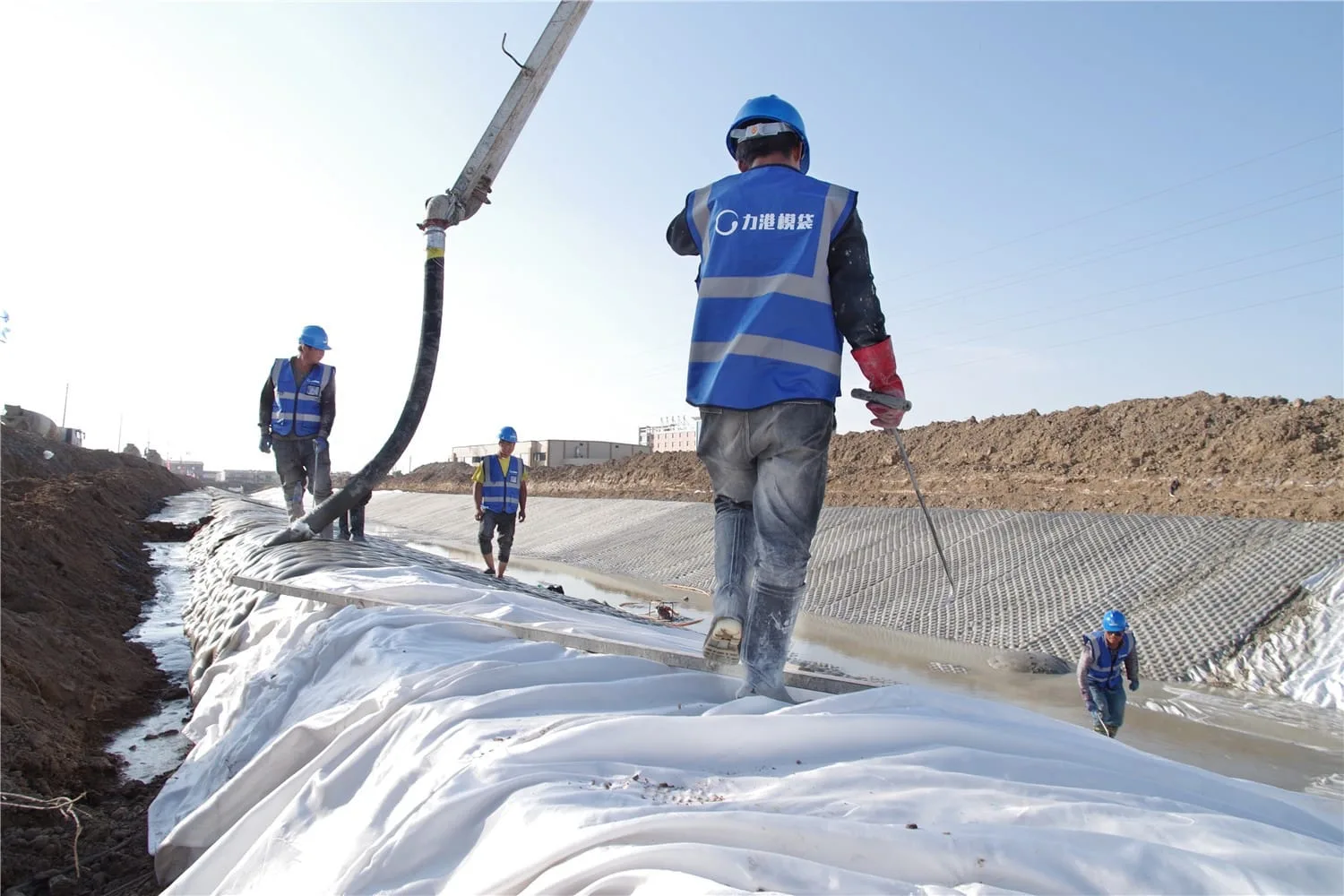

Crew installing grouted mattress on steep embankment slope
Application

Slope Protection with Grouted Mattress

Flexible concrete armour for embankments, dams, reservoirs, highways, and railways. Any slope angle. No formwork. 48-hour dispatch.

1:1.5
Steepest Slope Installed
50+ yr
Design Life
1,200 m²
Per Shift Output
48 hr
Dispatch from Order

Quick Answer

Grouted mattress is the preferred slope protection system for hydraulic and civil engineering projects where dewatering is impractical or costly. It installs on embankments, reservoir faces, and river banks with flow running, at 800–1,200 m² per shift. Design velocities up to 6.0 m/s (200 mm thickness). GRI GT16-compliant. Installed cost typically $25–45/m² — significantly less than rip-rap, gabions, or shotcrete.

The Case for Grouted Mattress

Armour That Moves With the Slope — and Stays Intact

Traditional slope protection methods — riprap, poured concrete slabs, or pre-cast panels — all require a stable, prepared substrate. If the slope settles, heaves, or moves, rigid systems crack and lose integrity. Maintenance becomes permanent.

Grouted mattress is a fabric-formed system: the geotextile mould adapts to the existing slope profile and the concrete fills into it. When minor differential settlement occurs after installation, the articulated mattress accommodates the movement without cracking. The protection remains intact through the design life. For slopes where ecological appearance matters, our vegetated grouted mattress allows grass to establish through the open-cell matrix. For slopes with high groundwater or tidal conditions, the filter point variant provides drainage relief.

Any Slope Angle
Installed on slopes up to 1:1.5 (34-)
Erosion Resistant
Resists rainfall, wave action & runoff
No Formwork
Fabric mould replaces conventional forming
Fast Install
500 m² slope section in one shift

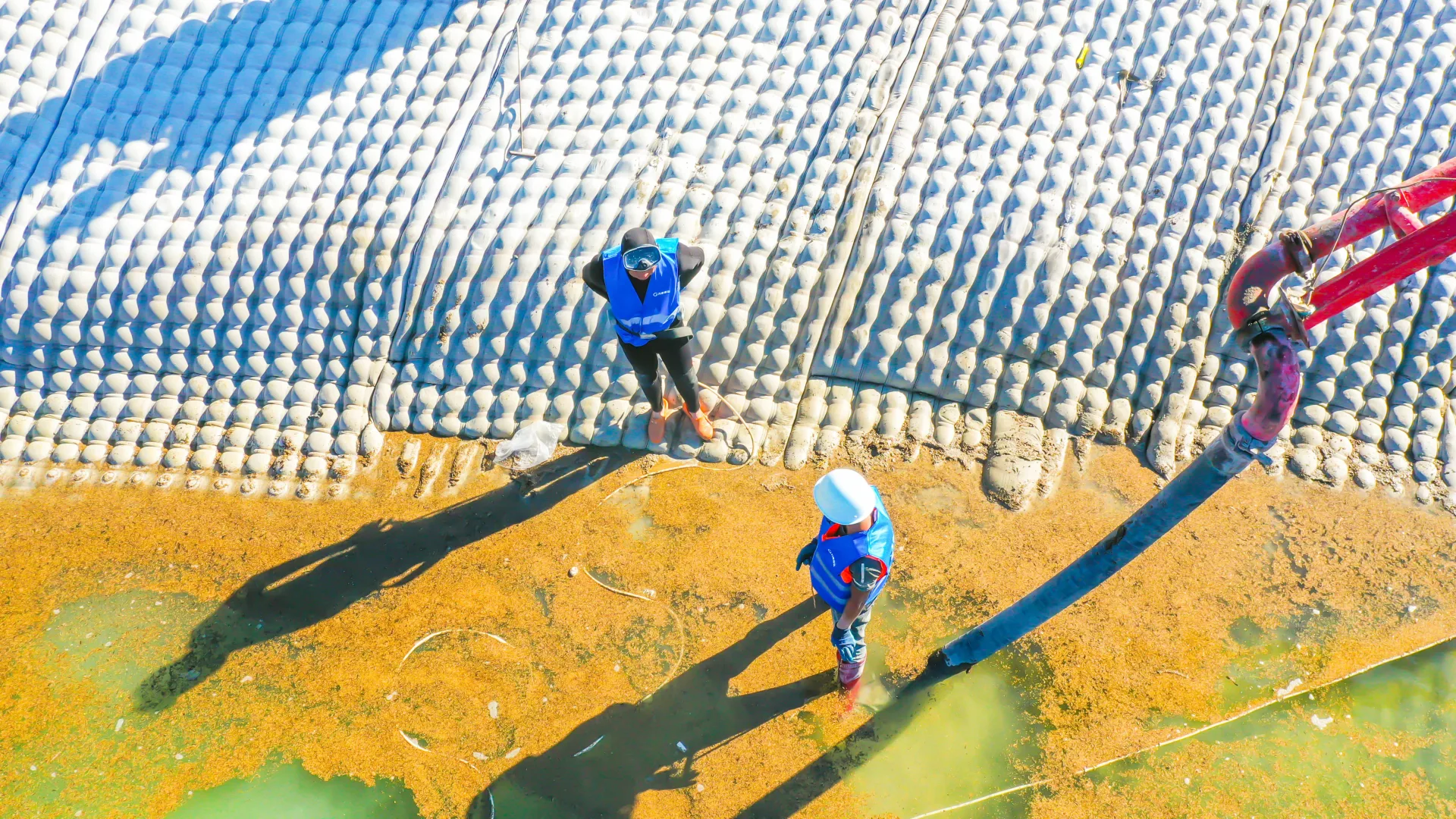

Aerial view of workers installing grouted mattress on slope
Installation crew on slope

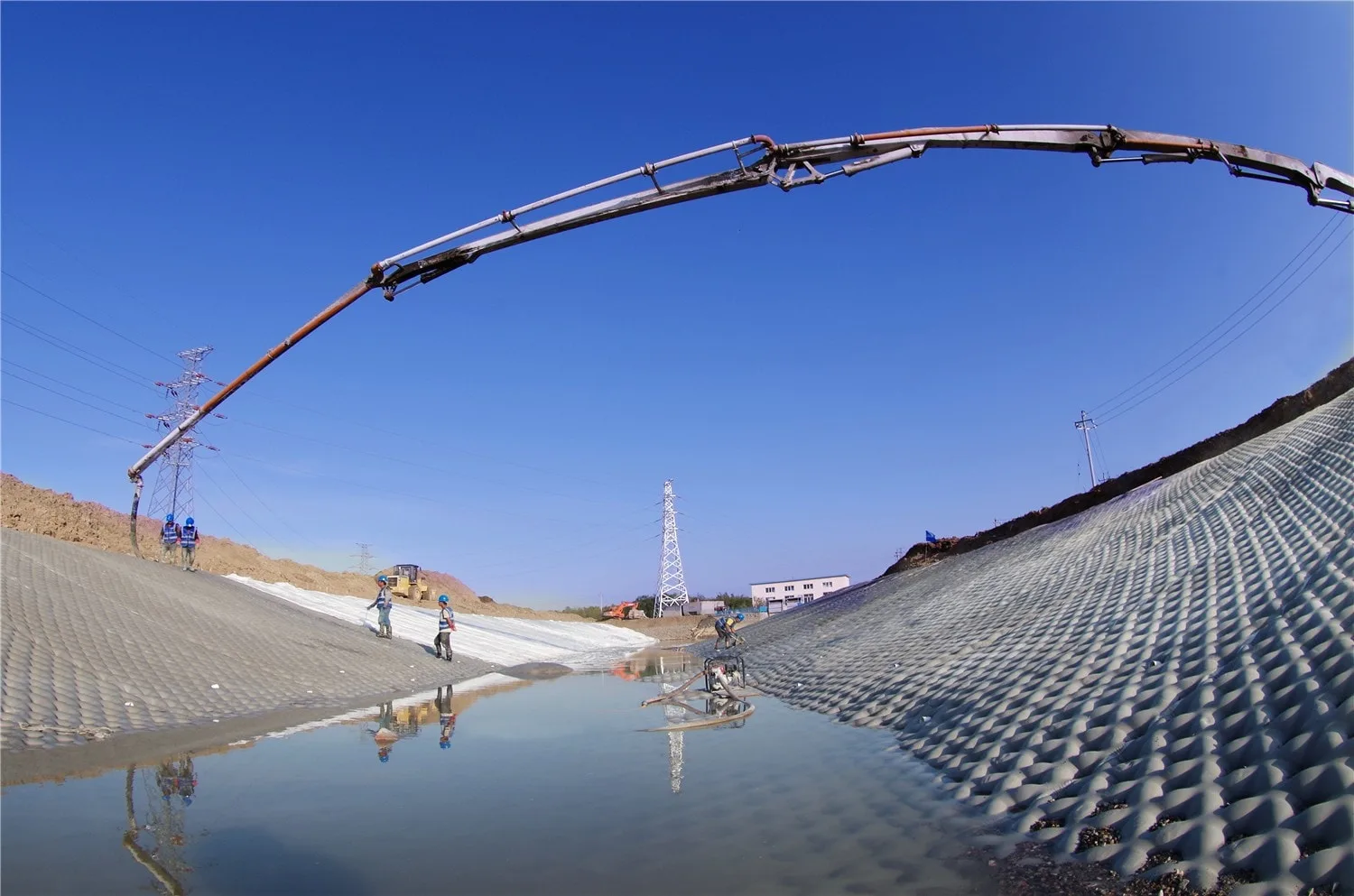

Pump boom arm over slope protection works
Project Gallery

What Do Completed Slope Protection Projects Look Like?

Slope installation crew anchoring fabric panels
Grouted mattress highway slope protection completed

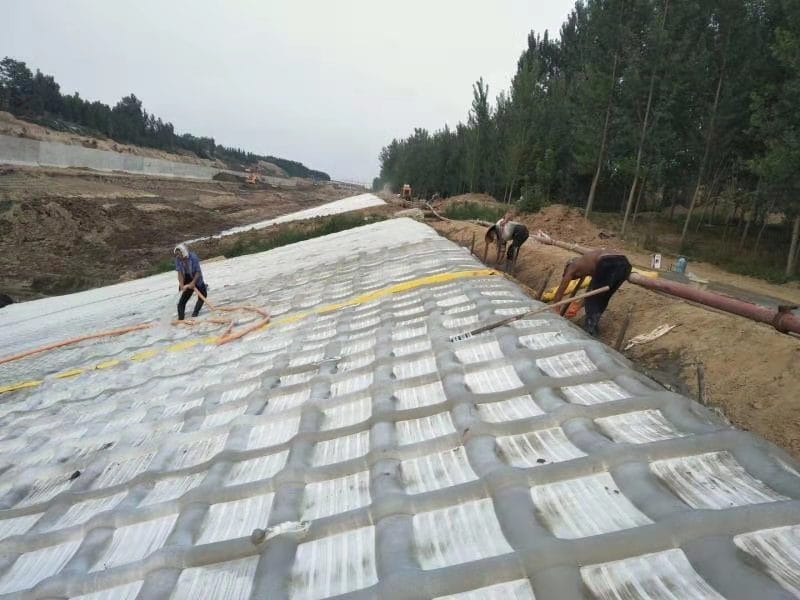

Workers laying grouted mattress panels on slope

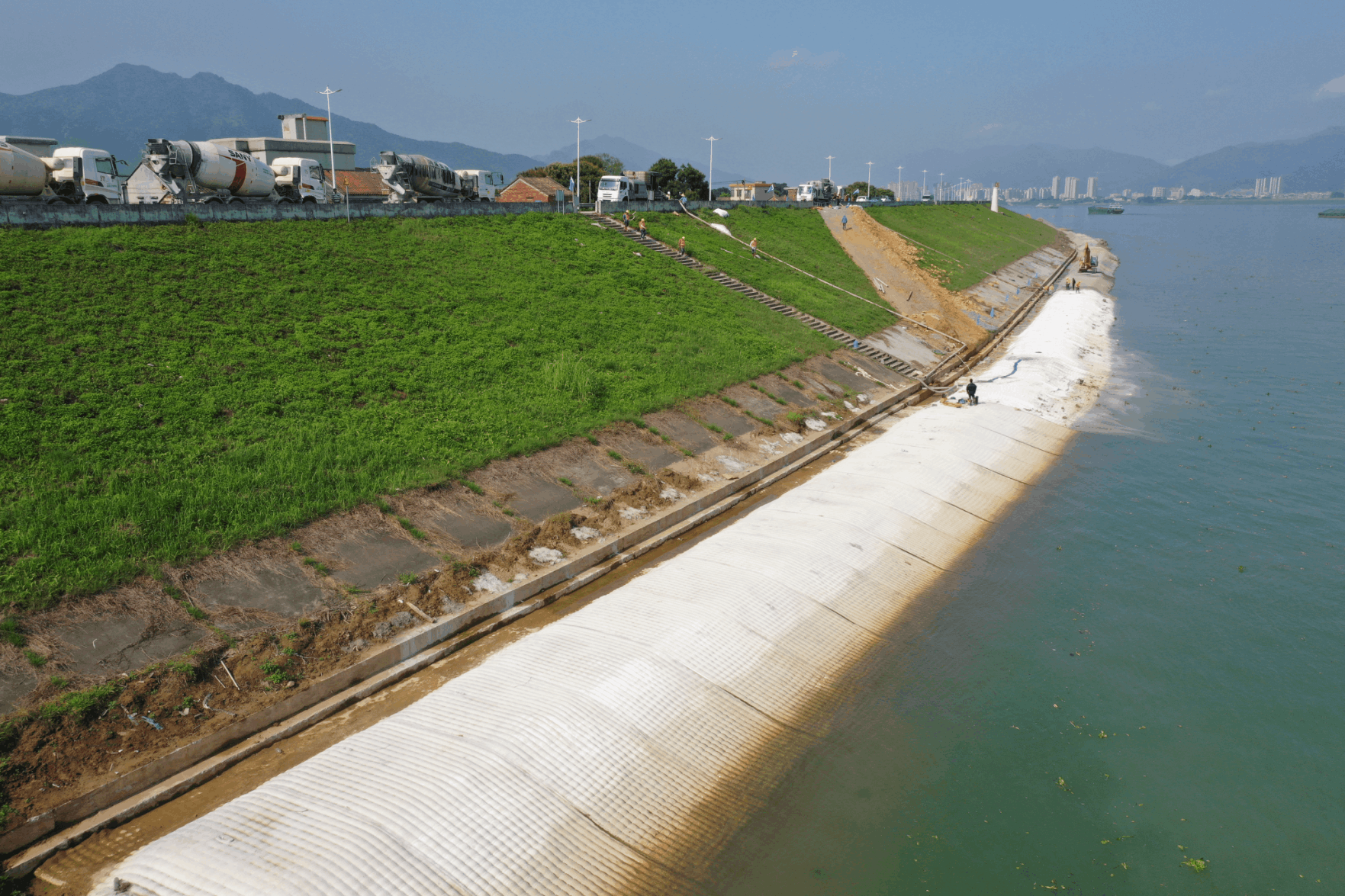

Coastal seawall slope installation with mixer trucks

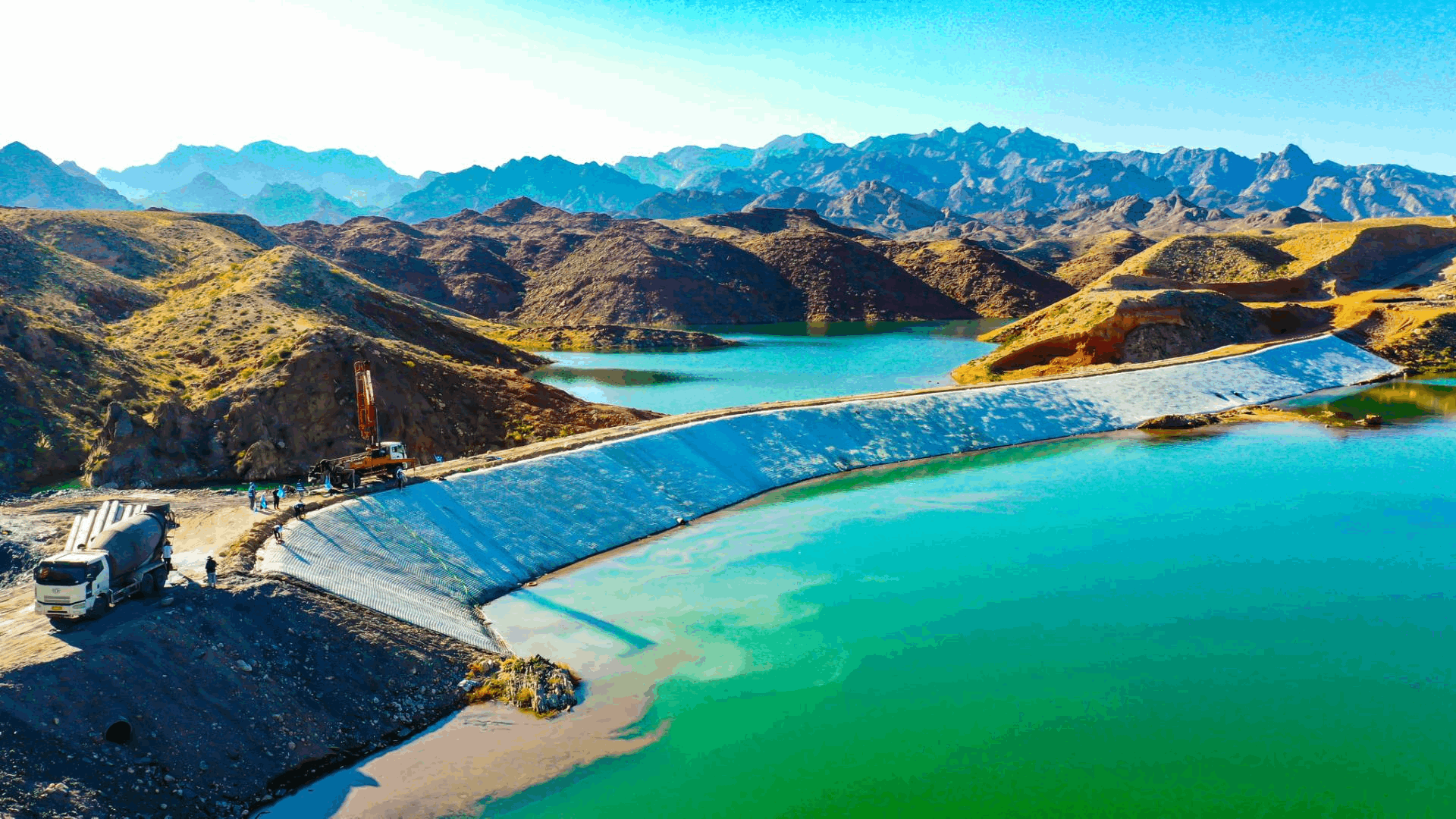

Mountain reservoir with grouted mattress dam face
Aerial view of large mining slope project
Applications

Which Slope Types Can Grouted Mattress Protect?

Highway & Railway Embankments

Highway & Railway Embankments

Road and rail embankments require durable, low-maintenance slope protection. Grouted mattress meets the load and velocity criteria of both applications and is approved by major infrastructure standards.

Dam & Reservoir Facing

Dam & Reservoir Facing

Upstream face protection on earth fill dams and reservoir slopes. The mattress withstands drawdown conditions, wave action, and ice loading — critical on mountain and high-altitude projects.

River & Channel Banks

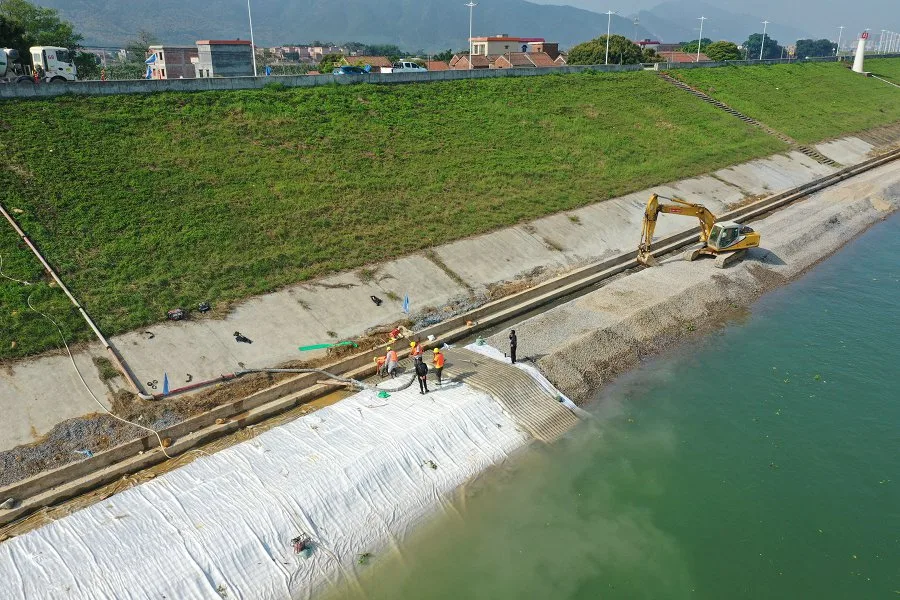

River & Channel Banks

Riverbank erosion protection where the bank is intermittently submerged. Grouted mattress withstands the scour velocity of flood events without requiring dewatering for installation.

Mining Pond Slopes

Mining Pond Slopes

Water retention pond slopes on mining sites are exposed to chemical loading and aggressive water. Grouted mattress provides chemical-resistant armour without ongoing maintenance.

Canal Bank Protection

Canal Bank Protection

Canal banks adjacent to lined channels where maintenance access is restricted. The mattress can be installed from the top of bank with a pump boom — no canal closure required.

Coastal & Tidal Slopes

Coastal & Tidal Slopes

Seawall faces, tidal flats, and coastal embankments where wave action and tidal cycling are the design loads. Filter point variant drains pore pressure during tidal drawdown.

Technical Data

Which Thickness Should I Specify for My Slope?

Select mattress thickness based on design flow velocity and slope angle. HydroBase engineers confirm the specification for your site conditions.

ThicknessMax Flow VelocityTypical Slope TypeMax Slope Angle
75 mm2.5 m/sLow rainfall embankments, gentle slopes1:3
100 mm3.5 m/sStandard embankments, highway slopes1:2
150 mm4.5 m/sReservoir facing, wave action zones1:1.75
200 mm6.0 m/sDam facing, high-velocity channel banks1:1.5

★ Most commonly specified. All thicknesses GRI GT16-compliant, compressive strength ≥17 MPa at 28 days. Filter point variant available for phreatic line applications.

Installation

How Is Grouted Mattress Installed on a Slope?

01

Survey & Specification

Slope angle, height, soil type, rainfall intensity, and hydraulic exposure are assessed. Mattress thickness, variant (standard, filter point, or vegetated), and anchoring details are confirmed.

02

Slope Preparation

The slope surface is trimmed and lightly compacted. No excavation, no shuttering, no toe preparation beyond design depth. The geotextile adapts to the existing surface profile.

03

Fabric Roll-Out & Seaming

Panels are rolled from the crest down to the toe. Adjacent panels are overlapped 300 mm and seamed. The fabric is tensioned and pinned to maintain contact with the slope.

04

Grout Injection & Curing

Concrete is pumped from the crest downward through injection ports. Workers on the slope check for uniform fill. Water misting begins within 30 minutes of each panel completing.

Crew & Equipment
One pump truck + 4-? person slope crew installs 500 m² per shift. Steeper slopes use a safety line system at no additional cost.
Crew positioning fabric panels on slope
Pump boom deploying grout on slope
Worker curing fresh mattress surface

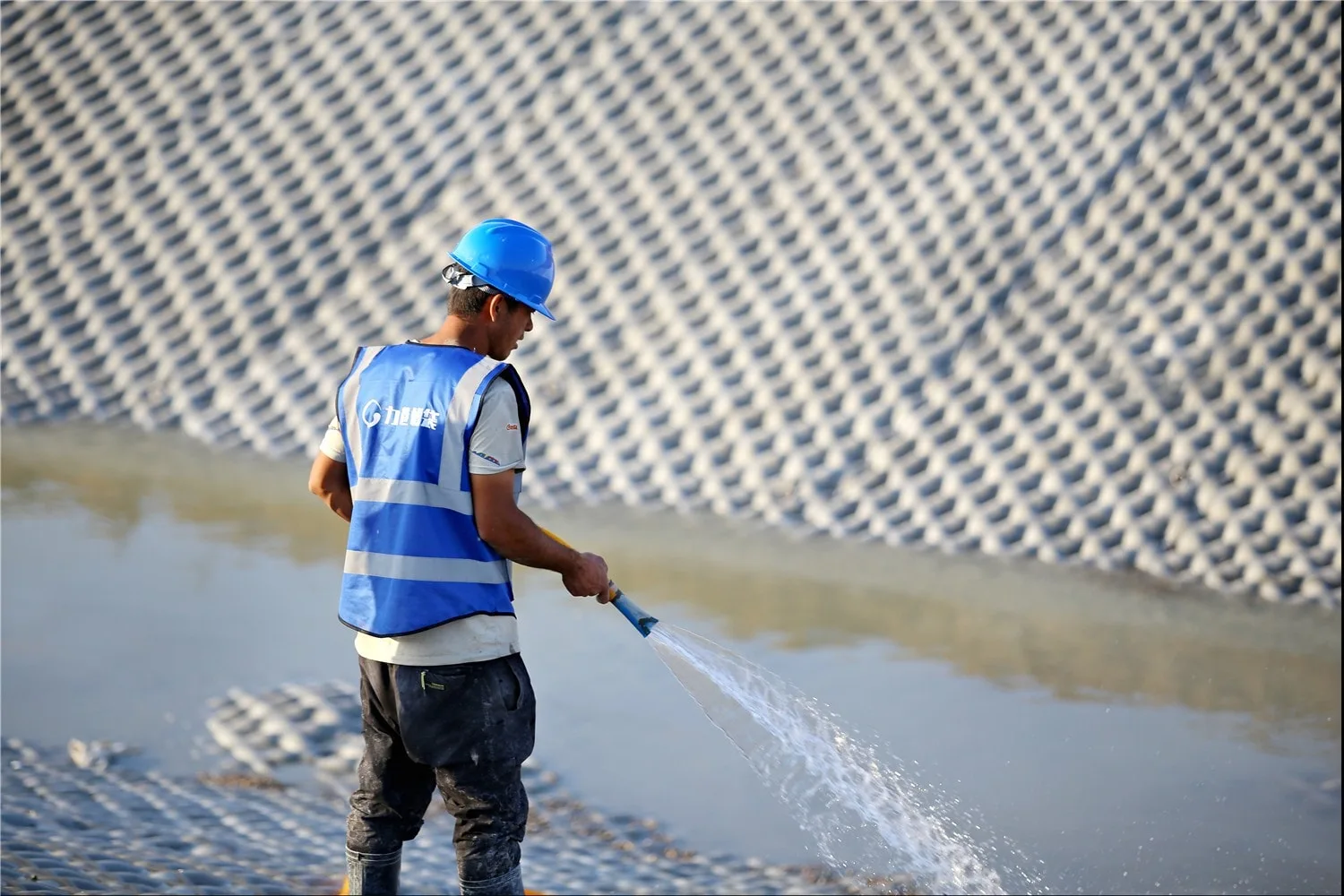

Curing water applied to newly grouted section
Comparison

How Does Grouted Mattress Compare to Rip-Rap, Gabions, and Shotcrete?

CriterionGrouted MattressRiprapConcrete Slab
Conforms to settlementFlexible — no crackingStone may shiftCracks under movement
Steep slope capabilityUp to 1:1.5Limited above 1:2Any angle (with anchors)
No substrate excavationFabric adapts to profileRequires graded bedRequires levelled base
Installation speed800–1,200 m²/day400–600 m²/day150–400 m²/day
Typical cost$35–55/m²$40–80/m²$70–120/m²
Design life50+ years30–40 years40+ years
MaintenanceMinimalRe-grading after floodJoint re-sealing
Vegetated optionAvailableNoneNone

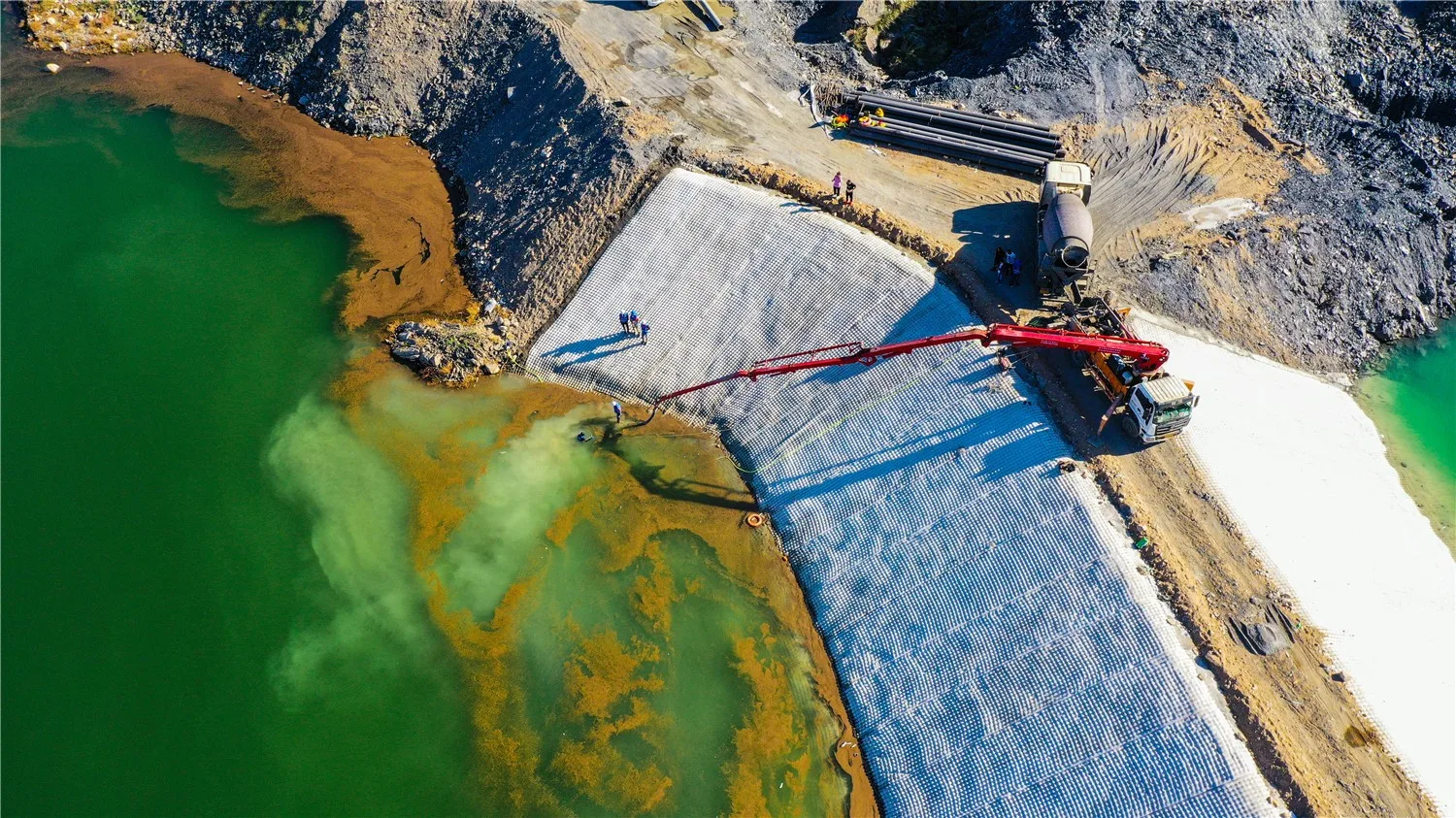

Aerial view of large mining slope protection project
Factory Direct

230+ Slope Projects. Three Variants. One Factory.

Road Embankments to Dam Facings
230+ slope installations across six countries. Same GRI GT16 QC standard applied to every project, regardless of size.
Three Variants for Any Condition
Standard for dry slopes. Filter Point where groundwater or tide creates uplift pressure. Vegetated where planning requires green cover.
48-Hour Dispatch, Cut to Your Geometry
Panels fabricated to your slope dimensions and shipped within 48 hours. No stock delays, no intermediary.
GRI GT16 — Third-Party Certified
ISO 17025-accredited test certificates on tensile strength, CBR, and seam strength — included with every order.
FAQ

Slope Protection with Grouted Mattress: Frequently Asked Questions

What is the steepest slope grouted mattress can be installed on?

We have installed on slopes as steep as 1:1.5 (vertical:horizontal). For slopes steeper than 1:2, anchor pins at 1 m centres are specified to prevent sliding during grout injection before the material cures. Our engineers confirm the anchoring design for your slope angle and height.

Can it be installed over a failed or unstable slope?

Yes. The geotextile fabric adapts to an irregular surface — including scour holes, failed slope faces, and existing rip-rap. The grout fills voids and bonds to the subgrade, restoring the profile without prior reconstitution in most cases.

Is drainage behind the mattress required?

For dry slopes with no artesian pore pressure, the standard (impermeable) mattress is used and no additional drainage is needed. For slopes with high groundwater or tidal fluctuation, our filter point variant provides engineered drainage relief and prevents hydrostatic uplift.

Can grouted mattress be used on the upstream face of an earthen dam?

Yes — this is one of the most common applications. The mattress provides wave action resistance and seepage control on reservoir-facing slopes. We supply to dam operators and water authorities for both new construction and dam rehabilitation projects.

Does it need special plant or equipment on site?

No specialist plant is required. A standard concrete pump truck and two transit mixers are the only equipment needed. The pump truck can operate from the crest of the slope — no access road down the face is necessary.

How is the mattress fixed at the top of the slope?

A trench anchor is excavated at the crest (typically 300 mm - 300 mm), the top edge of the mattress is folded into the trench, and grout is pumped to fill it simultaneously with the main mattress. This creates an integral mechanical anchor that eliminates the risk of top-edge roll-back.

Specify Your Slope Protection

Provide slope geometry, hydraulic conditions, and project timeline — we'll return a specification and BOQ within 48 hours.

Chat on WhatsApp
